Company: Equinix
Project Summary
Equinix's 45-day order-to-activation time made us uncompetitive. From research to launch, I led the UX transformation that reduced it 98% to <24 hours, generating 87% revenue growth.
Responsibilities: END-TO-END ux
Timeline & Team

6 months, with a Product Owner, Technical Product Manager, Engineering, & external visual designer
Results

COMPANY & PRODUCT OVERVIEW

PROCESS

DISCOVERY & RESEARCH

Learn IX domain

Heuristic & competitive analyses

Consult related products’ designers

Assess 2 baby design systems
DISCOVERY

Ramped up on existing process
Key finding: Customers submitted order, then Equinix departments consulted with customers to customize and negotiate
Follow-ups added up
Opportunity to restructure process to collect all information before placing order

RESEARCH --> STRATEGIC SHIFT

Competitor customers are less technically knowledgeable

I realized competitors' speed was one just part of a larger strategic difference. Their designs focused on small and medium businesses (SMB). So I pushed our team to reframe our goal from the 2-day target to "add support for SMB customers."

Identified 3 design imperatives
DESIGN STRATEGY

Make process, logic, and pricing transparent and visible

Add in-context educational content

Integrate all ordering scenarios and edge cases into wizard

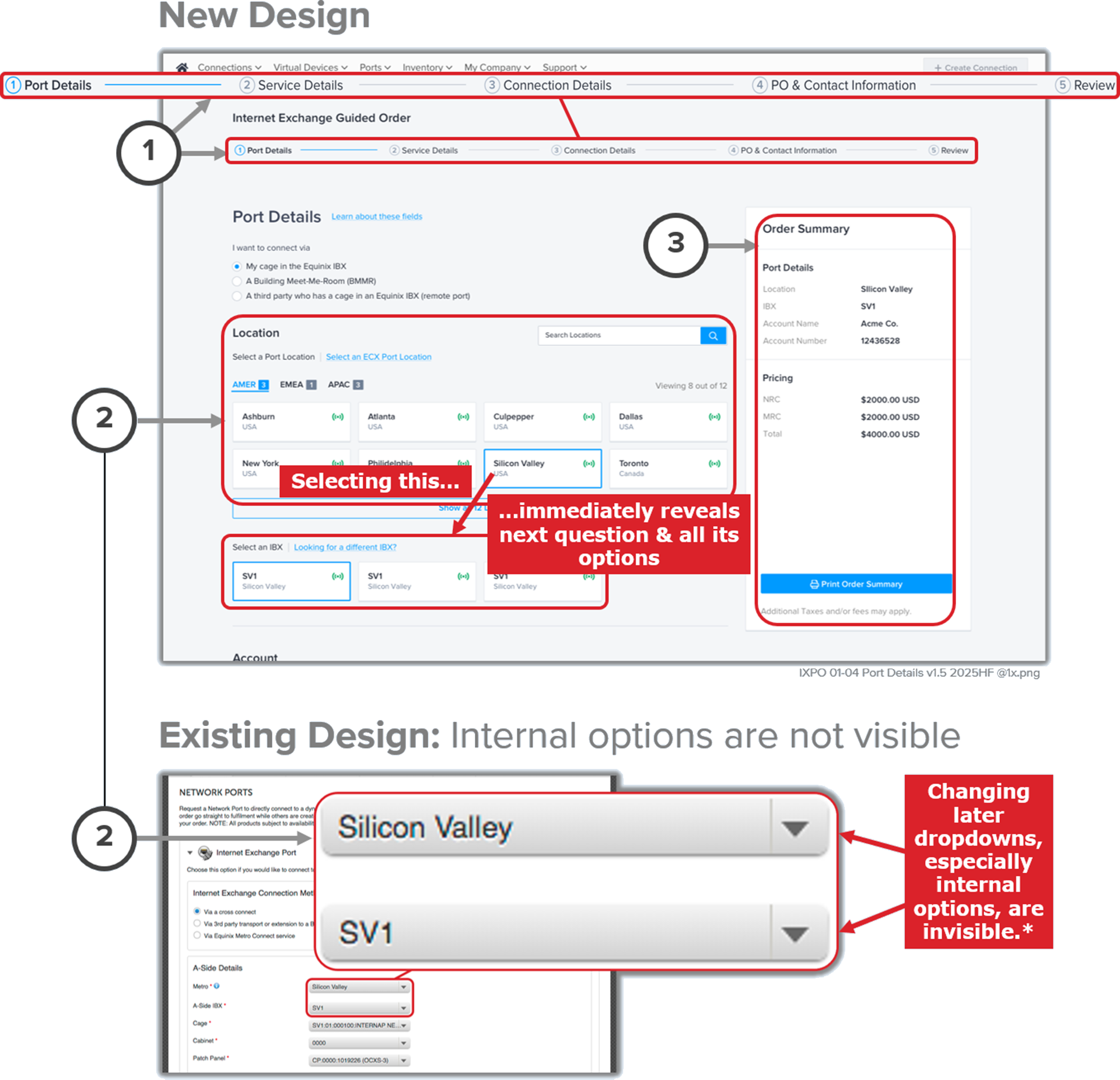

SOLUTION: VISIBILITY & STRUCTURE

* Supported by 2cm foveal perception at screen distances and heuristics from Don Norman, Jakob Nielsen, Ed Hutchins, and Ben Schneiderman.
<PROJECT KICKOFF, color #999999>
Hey there, this is a bulleted list, but, sadly, there's no way in Semplice v6 to increase the spacing between the bullets, just between each and every line--but all the text is #333333:
And, after the list... Have Fun!
Hey there, this is your CSL supplementary information as a paragraph with color #333333. Have Fun!
SOLUTION: INTEGRATION & COMPLETENESS

DESIGN SYSTEM INNOVATION

BUSINESS RESULTS
98% reduced
+87%
+73%
"...activation in <24 hours"
Task time
Monthly revenue
Ports sold/month
User testimonial
Customers bought more expensive ports
Changed behavior
STRATEGIC iMPACT & LESSONS

Research-driven design decisions (transparent pricing, educational content, visible logic) made IX accessible to SMB segment—a strategic outcome beyond original brief.

Established wizard template, tile patterns, integrated workflows used across all Equinix port products—created company-wide ordering consistency from single project.

Research-driven design decisions (transparent pricing, educational content, visible logic) made IX accessible to SMB segment—a strategic outcome beyond original brief.
SUMMARY

Smashed original 2-day goal: Transformed 45-day high-touch process into a comprehensive online experience with a <24-hour activation time
Strategic shift from 2-day goal to adding SMB customers: expanded market, added revenue, and led to customers buying more expensive ports
Platform-wide impact: Design system patterns and wizard template adopted across 6+ existing products and used in subsequent new products
"Thanks for all your efforts last year to make these flows so good they're changing perceptions of interacting with Equinix. This project is going to have a huge impact."
Product Owner, Greg Dendy
